Quick Links
- MLRP Project Application
- Demand Reduction Project Concept Form – use this form to develop and share your ideas for a land repurposing project with ETSGSA
- Request Technical Assistance by contacting ETSGSA by email at etsgsa-support@formationenv.com or by phone at (209) 407-1233
- Frequently Asked Questions
- Turlock Multibenefit Agricultural Land Repurposing Plan – In development
- Turlock MLRP Viewer tool
- ETSGSA Incentive Payment Framework
What is the Turlock Multibenefit Land Repurposing Program (MLRP)?

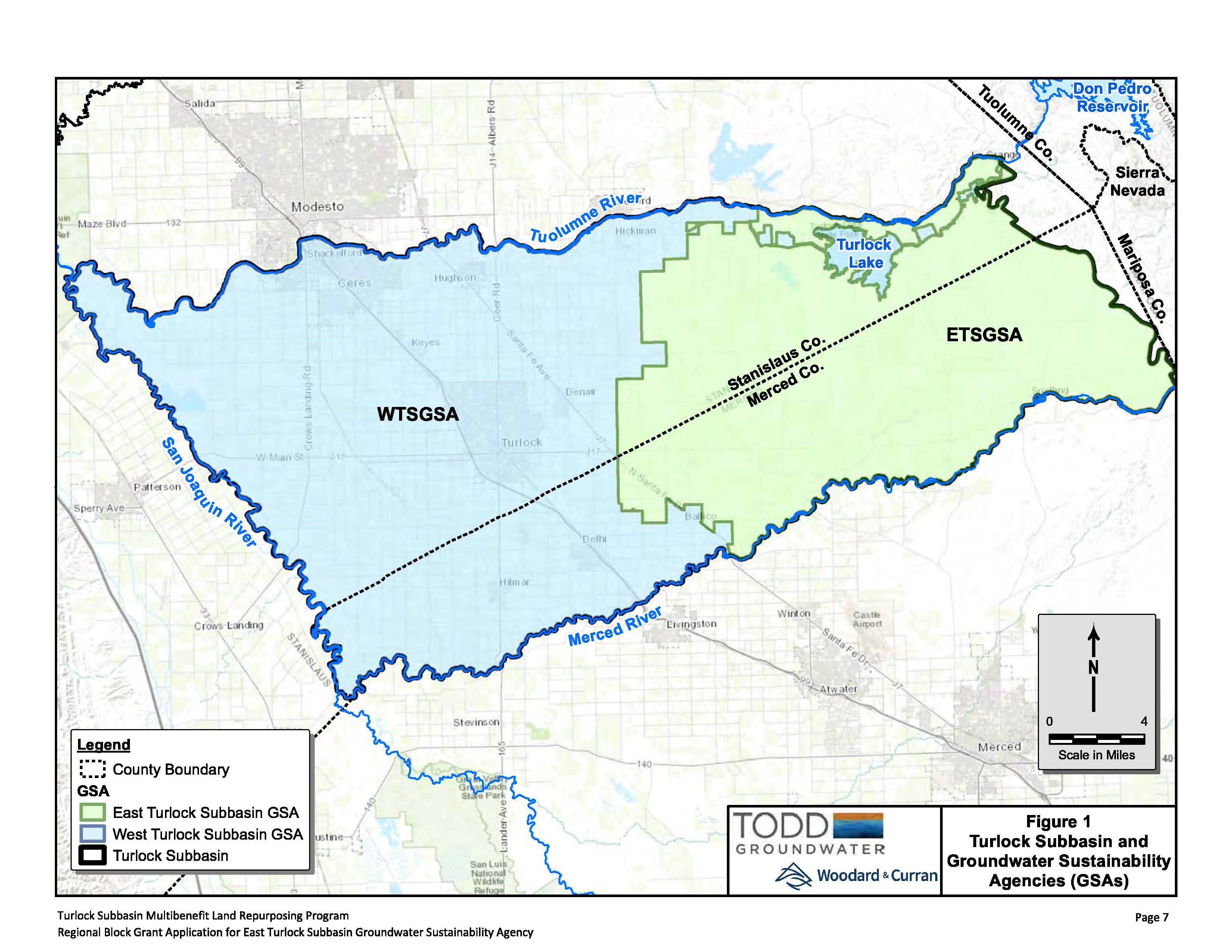

The Turlock MLRP is a program being developed by the East Turlock Subbasin Groundwater Sustainability Agency (ETSGSA) and funded through a $8.89 million grant from the California Department of Conservation (DOC) that aims to help achieve groundwater sustainability in the
Turlock Subbasin
through strategic, incentivized repurposing of agricultural lands to alternative high-value land uses that use less water and provide other benefits, including enhanced habitat, groundwater recharge, flood risk mitigation, soil health, and benefits to communities. This program aims to guide and prioritize locally developed projects that repurpose agricultural land to achieve multiple benefits in alignment with regional goals. The MLRP's collaborative approach involves multiple partners, including groundwater managers and planners, engineers and scientists, community outreach leaders, and local stakeholders, to ensure a comprehensive and inclusive approach.
The Turlock MLRP includes:
- Development of a Multibenefit Agricultural Land Repurposing Plan (MALRP)
- Outreach and Engagement with stakeholders
- Development of tools and resources to assist interested parties in developing and implementing MLRP projects
- Solicitation and prioritization of MLRP projects
- Project implementation
- Monitoring and reporting

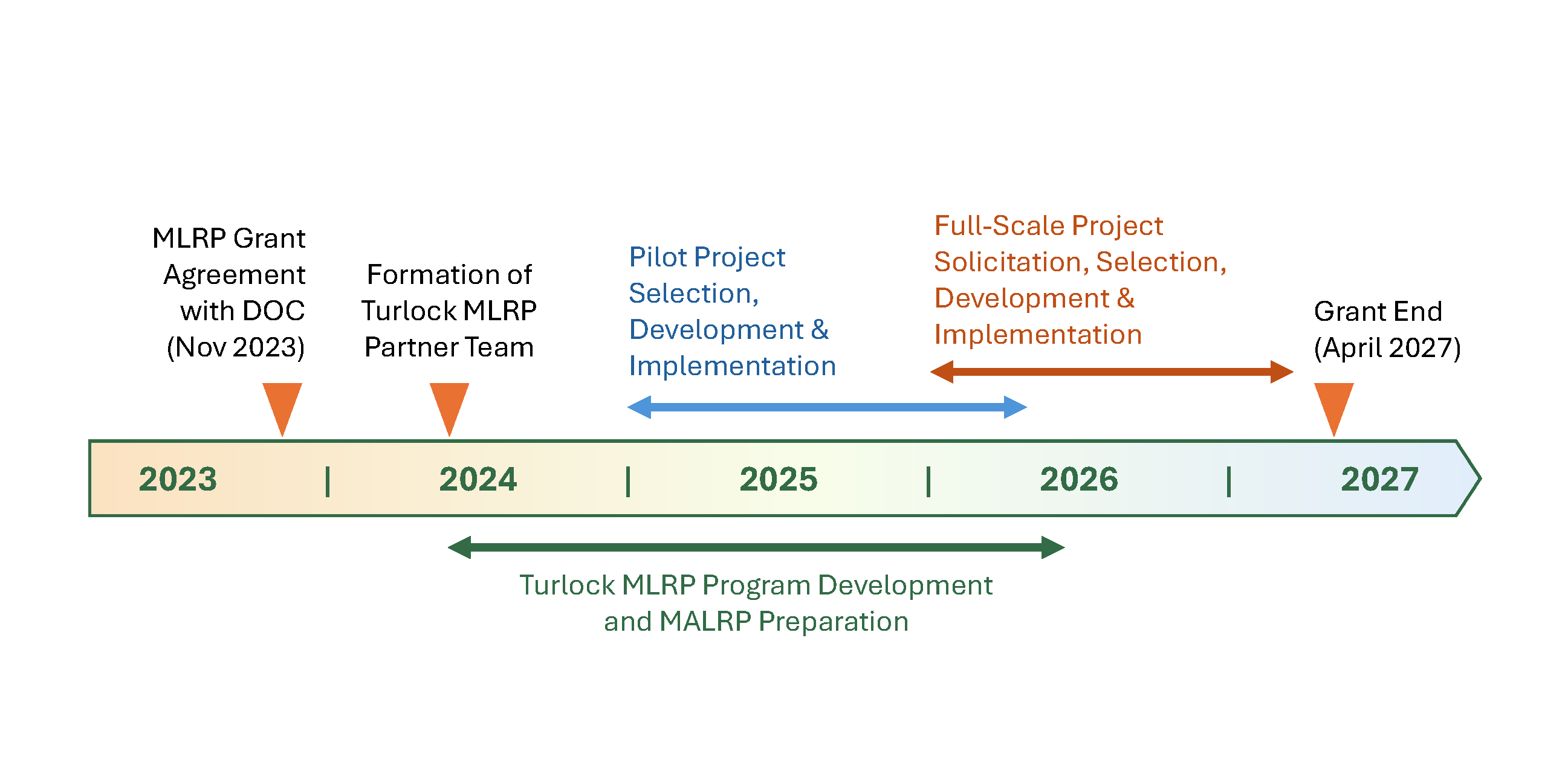

Turlock MLRP Timeline
Repurposing Opportunities and Approaches
Multibenefit land repurposing projects convert irrigated crop lands to alternative uses that reduce groundwater demand and provide additional benefits to the environment and the community. The ETSGSA has developed a set of land repurposing practices that can be implemented individually or in combination as part of an MLRP project. Click on the links below to learn more about these practices, or scroll through the Turlock MLRP Story Map to explore the possibilities of a re-imagined agricultural landscape in ETSGSA.
-
MLRP Extended Multibenefit Fallowing cutsheet
|
MLRP Vegetative Cover DRAFT Implementation Standard
-

Orchard Swale Rewilding cutsheet
|
MLRP Rewilding DRAFT Implementation Standard
-

Recharge and Retention Basins cutsheet
|
MLRP Constructed Basins DRAFT Implementation Standard
-
Floodplain Reconnection cutsheet
-

Floodflow Spreading cutsheet
-
Agricultural Buffer Zones cutsheet
Got an idea for a different type of multibenefit land repurposing project? No problem! Contact ETSGSA at etsgsa-support@formationenv.com to share your ideas.

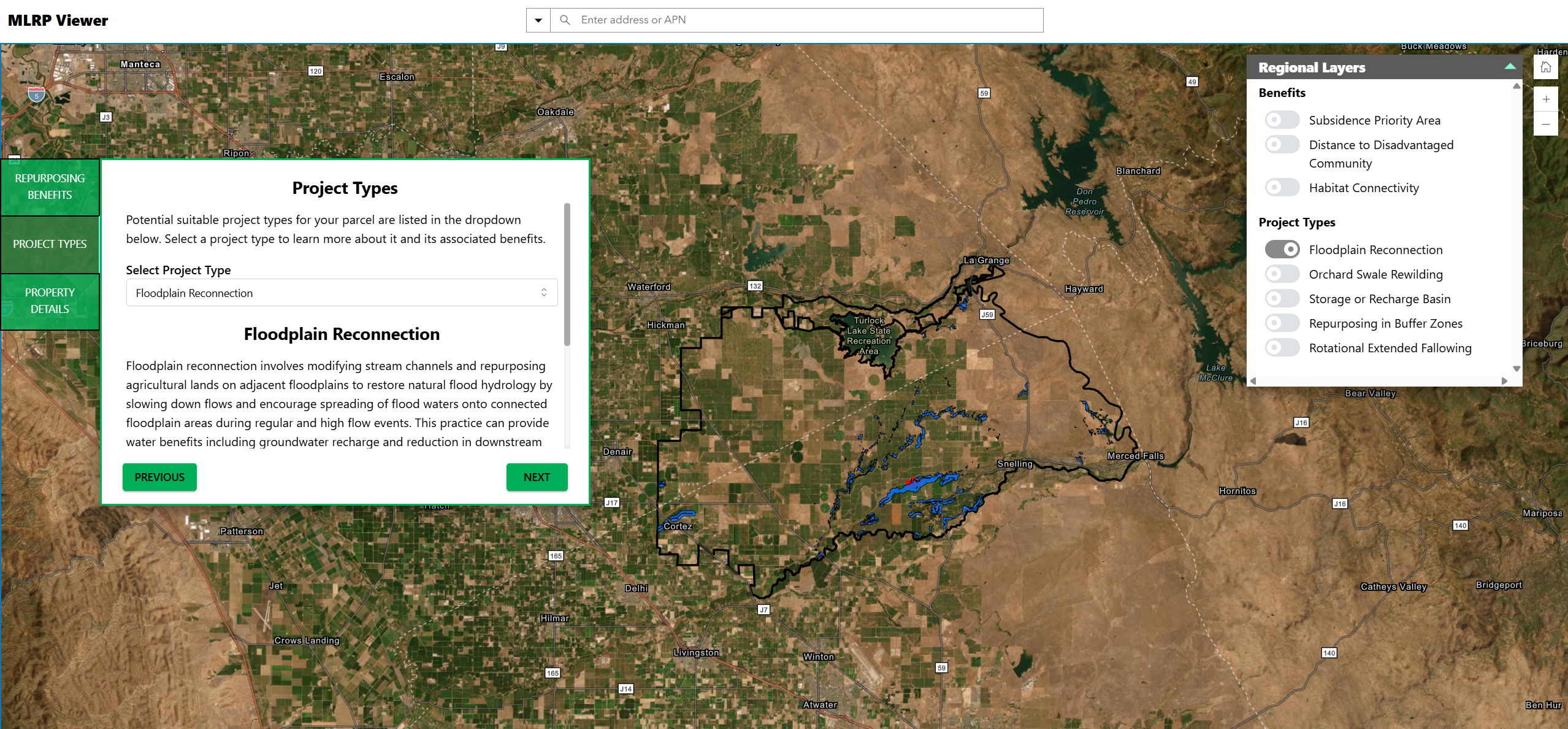

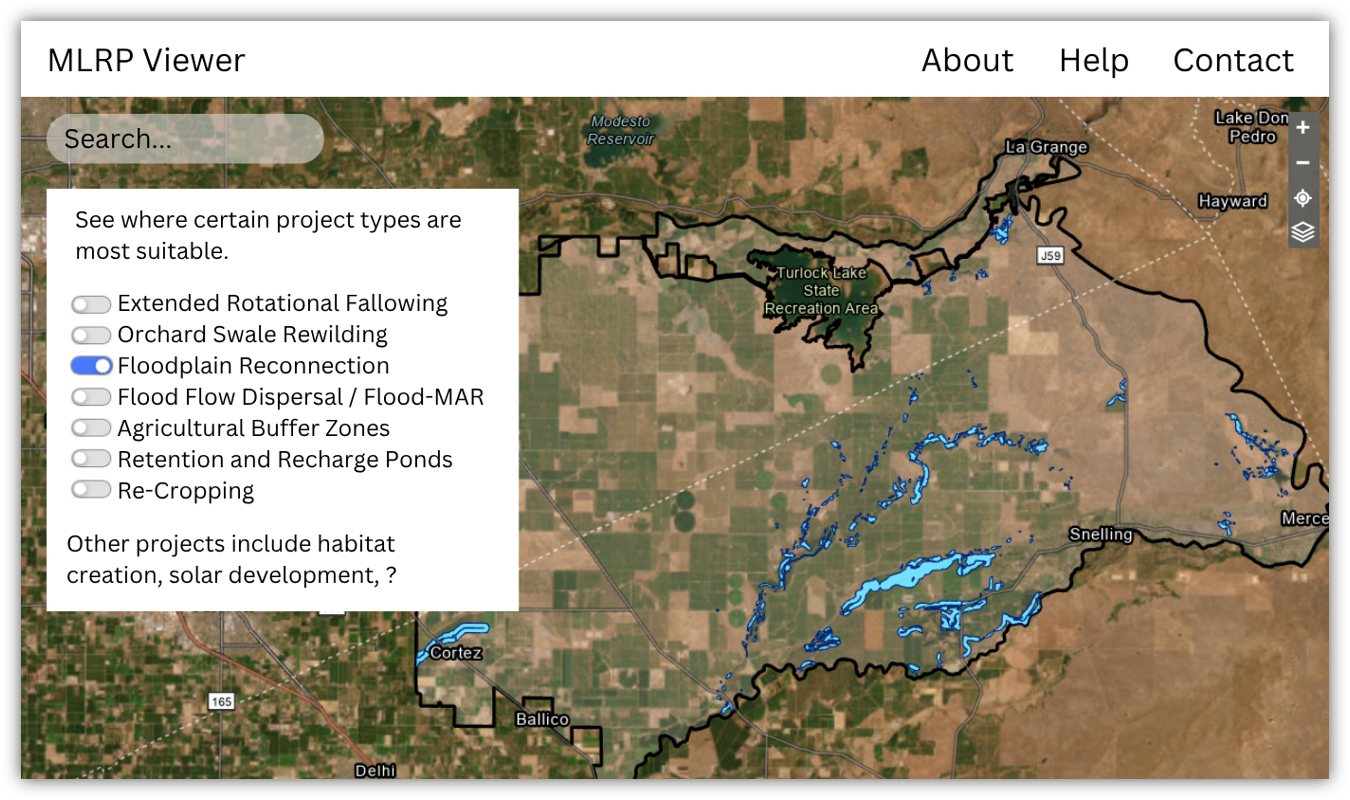

The Turlock MLRP Viewer tool is designed to assist landowners in exploring suitable land repurposing opportunities, providing them with information that they can then use to apply for MLRP.
Launch Turlock MLRP Viewer toolHow Multibenefit Land Repurposing Benefits the Turlock Subbasin
Consistent with statewide (DOC) guidance, the Turlock MLRP aims to achieve benefits for the Turlock Subbasin within four main benefit categories:
Groundwater Sustainability
Habitat
Disadvantaged Communities
Local Economy
Depending on the specific land repurposing alternative, potential broad-based benefits may include one or more of the following:
- Water Conservation: Water savings is the primary benefit of multibenefit land repurposing, and all land repurposing alternatives contribute to water conservation by reducing irrigation needs or capturing water more effectively.
- Groundwater Recharge: Alternatives like Recharge and Retention Basins and Floodflow Dispersal directly support groundwater recharge.
- Habitat Creation and Biodiversity Enhancement: Orchard Swale Rewilding, Floodplain Reconnection, and Recharge and Retention Basins promote biodiversity through habitat creation for pollinators and other species.
- Flood Risk Reduction: Floodflow Spreading, Floodplain Reconnection, Orchard Swale Rewilding, and Recharge and Retention Basins can help mitigate flood risks by managing excess water flows during wet periods.
- Community Benefits: Agricultural Buffer Zones and other alternatives may provide direct benefits to communities by improving local environmental quality and reducing exposure to hazards. Other benefits listed here constitute indirect benefits to communities.
- Climate Resilience: Water savings and drought-tolerant vegetation as a result of multibenefit land repurposing practices contributes to the region's ability to withstand climate-related weather extremes.
Benefits to Landowners Implementing MLRP Projects
Participation in the Turlock MLRP can also provide benefits to the landowners implementing MLRP projects on their land:
- Incentive Payments: Using grant funds from the state, the ETSGSA will incentivize MLRP projects by providing incentive payments to participating landowners to implement and maintain their projects.
- Soil Health Improvement: Cover cropping implemented as part of MLRP projects can improve soil health through reduced erosion and enhanced organic matter.
- Pollinator Benefits: MLRP projects that involve repurposing to pollinator-friendly vegetative cover can boost pollinator and beneficial insect populations, providing benefits to adjacent cropped areas.
- Water Security: Many MLRP alternatives result in more water staying on the land through retention on the surface, in the soil, and/or in the underlying groundwater.
Community Engagement & Participation
Community and public engagement is a key part of the MLRP planning process, and participation is open to all interested parties.
Outreach and Engagement Events
MLRP topics are frequently discussed at the following ETSGSA events, to which all participants are welcome:
- ETSGSA Board of Directors meetings, open to the public – on the last Thursday of every month
- ETSGSA Technical Advisory Committee (TAC) meetings, open to the public – on the second Tuesday of every month
- ETSGSA MLRP Stakeholder Advisory Committee (SAC) meetings, open to the public – held quarterly
- ETSGSA Grower Ad-Hoc Committee meetings, open by invitation (contact ETSGSA if interested in attending) – scheduled as needed
Outreach Meeting Materials
- ETSGSA Fee Workshop, Nov 19, 2024
- Community Meeting, Dec 10, 2024
- SAC Meeting #1, June 2, 2025
- SAC Meeting #2, July 28, 2025
- SAC Meeting #3, September 29, 2025
- Turlock Tree & Vine Expo presentation materials, November 11, 2025 (updated)
- SAC Meeting #4, December 11, 2025
- SAC Meeting #5, March 24, 2026
Get Involved
- Fill out our Community Survey
- Attend ETSGSA Board meetings, TAC meetings, and SAC meetings
- Provide feedback through the Contact Us section below
MLRP Calendar
How it Works

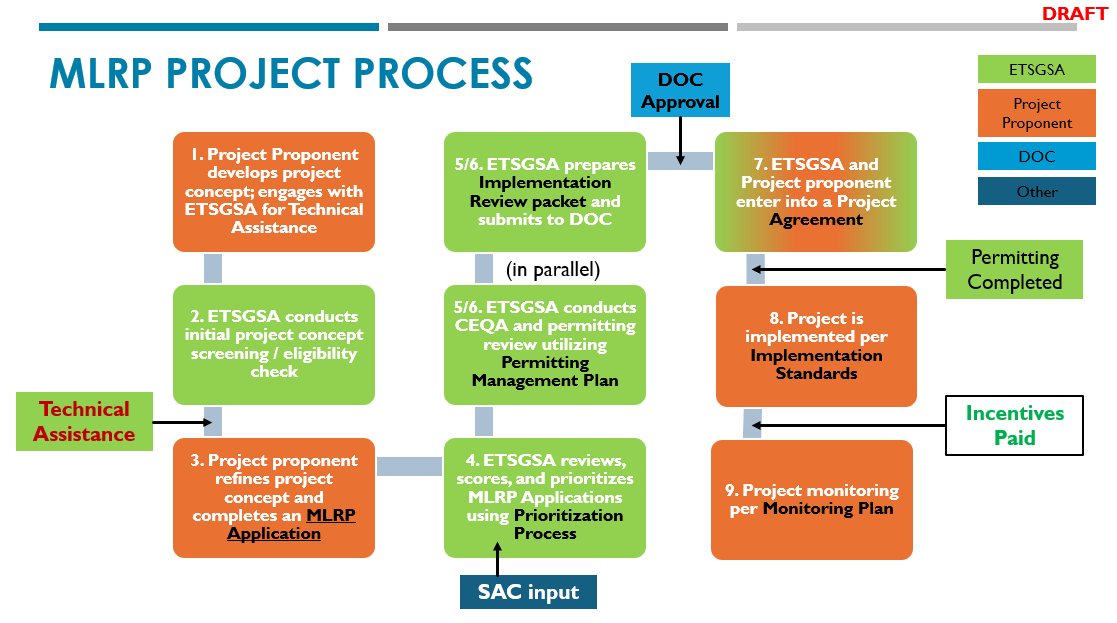

The process to develop and implement a multibenefit land repurposing project under the Turlock MLRP is being developed, with a focus on providing useful guidance on implementation strategies, transparent information on incentives and requirements, and an inclusive planning process. Subject to refinement by the ETSGSA, the process as currently envisioned will involve the following steps:
- Project proponent develops a project concept – Project proponents (typically landowners) formulate ideas for land repurposing projects, and may request Technical Assistance from the ETSGSA. Optionally, the Demand Reduction Project Concept Form may be used to share land repurposing project ideas with the ETSGSA.
- ETSGSA conducts initial project concept screening – The ETSGSA reviews the project concept to assess if it aligns with MLRP goals, or if it is better suited for another ETSGSA program.
- Project proponent refines project concept and completes an MLRP Project Application – For project concepts aligned with the ETSGSA MLRP goals, the project proponent further develops their project concept and completes and submits to the ETSGSA an MLRP Project Application in accordance with instructions and guidance. The project proponent is encouraged to seek Technical Assistance and guidance documents provided by the ETSGSA (e.g., Implementation Standards and mapping tools) during project development.
- ETSGSA reviews, scores, and prioritizes MLRP Applications – The ETSGSA applies an objective scoring framework followed by committee review to prioritize projects for funding.
- ETSGSA conducts CEQA and permitting review – The ETSGSA conducts a CEQA analysis, including desktop and/or onsite surveys, and documents CEQA compliance. The CEQA analysis informs project permitting requirements. The project proponent is responsible for obtaining permits and complying with all requirements under those permits and the CEQA documentation.
- ETSGSA prepares Implementation Review packet and submits to DOC – The Department of Conservation (DOC) must review projects before grant funding is made available. The ETSGSA, in coordination with the project proponent, prepares the DOC Implementation Review packet based on the project Application and submits it to DOC for review.
- ETSGSA and Project proponent enter into an Incentive Agreement – Once approved by DOC, the project is drafted into an Incentive Agreement that is executed by both the ETSGSA and the project proponent. Upon execution, the ETSGSA pays the project proponent a lump-sum incentive payment.
- Project is implemented – The project proponent implements the project in accordance with the Incentive Agreement, applicable Implementation Standards requirements, and associated recommended best practices. Projects may be self-implemented, contractor-implemented, or a combination of the two.
- Project monitoring – The project is monitored throughout the duration of the Incentive Agreement term (10 year minimum) in accordance with a Monitoring Plan to ensure that the desired outcomes are met.
Resources & Information
Statewide Program Documents
Turlock Subbasin Resources
- Stakeholder Outreach and Engagement Plan
- Turlock Subbasin Groundwater Sustainability Plan
- ETSGSA Groundwater Accounting Platform
- Turlock Subbasin MLRP Flyer (English)
- Turlock Subbasin MLRP Flyer (Spanish)
- MLRP Project Process Flowchart
- Land Suitability and Yield Assessment for Multibenefit Land Repurposing in East Turlock Subbasin GSA
- MLRP Grant Agreement between ETSGSA and CA Department of Conservation
- Multibenefit Agricultural Land Repurposing Plan (MALRP) – in development
Information for Project Proponents
- MLRP Project Application
- Demand Reduction Project Concept Form – use this to share your ideas for a land repurposing project with ETSGSA
- MLRP Practices Cut-sheets – learn about ETSGSA land repurposing practices
- MLRP Vegetative Cover DRAFT Implementation Standard
- MLRP Rewilding DRAFT Implementation Standard
- MLRP Constructed Basins DRAFT Implementation Standard
- MLRP Stormwater Ponds DRAFT Implementation Standard
- MLRP General Earthwork DRAFT Implementation Standard
- ETSGSA Incentive Payment Framework
- MLRP Project Monitoring Plan (DRAFT)
Project Team
The Turlock MLRP is being developed through a collaborative effort of the ETSGSA and the Partners and Collaborators listed below.
Partners
Collaborators
- Merced County
- Stanislaus County
- West Turlock Subbasin Groundwater Sustainability Agency
Contact
If you have any questions or would like more information about the Turlock Multibenefit Land Repurposing Program, please contact ETSGSA at:
Email: etsgsa-support@formationenv.com
Phone: (209) 407-1233
